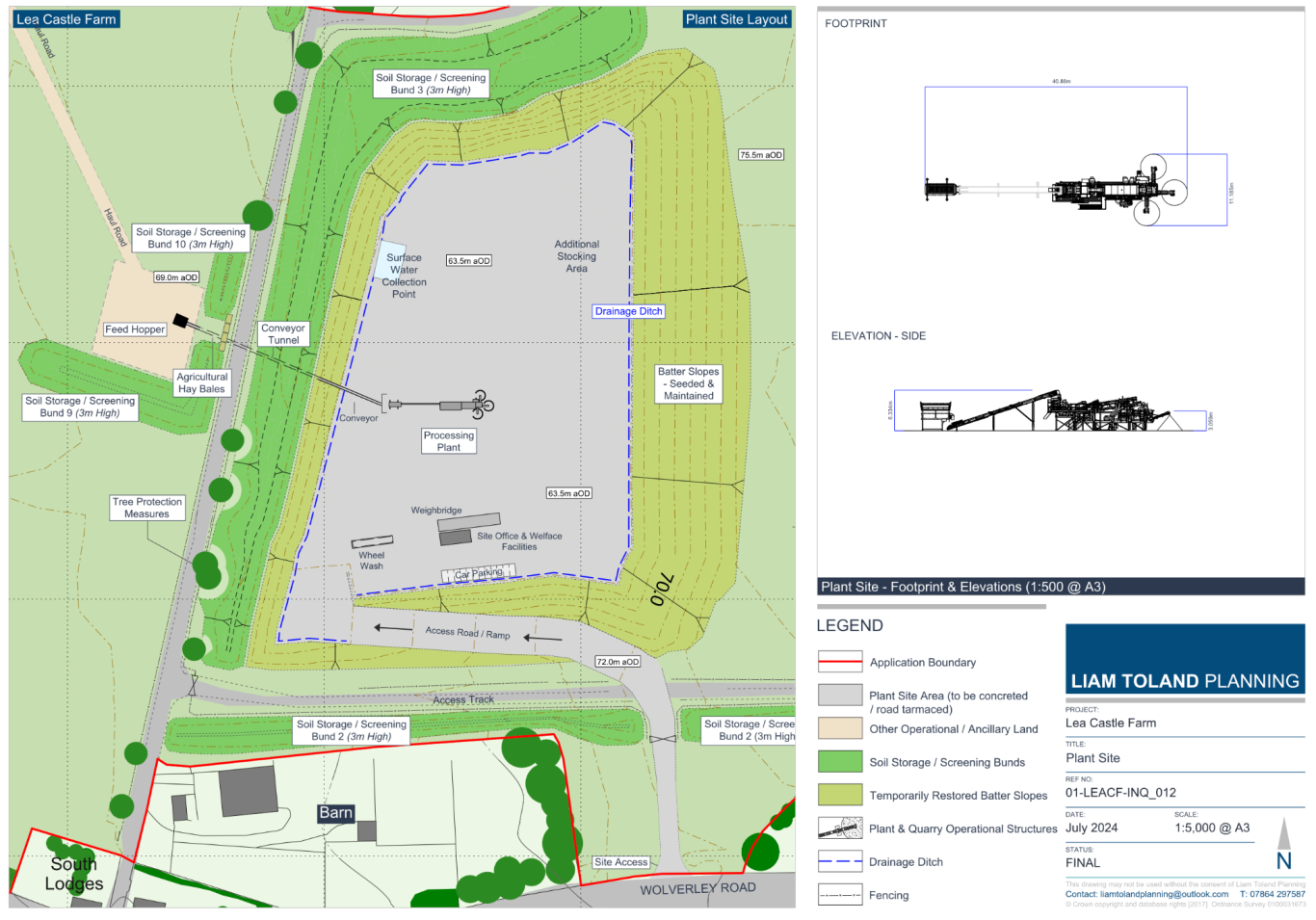

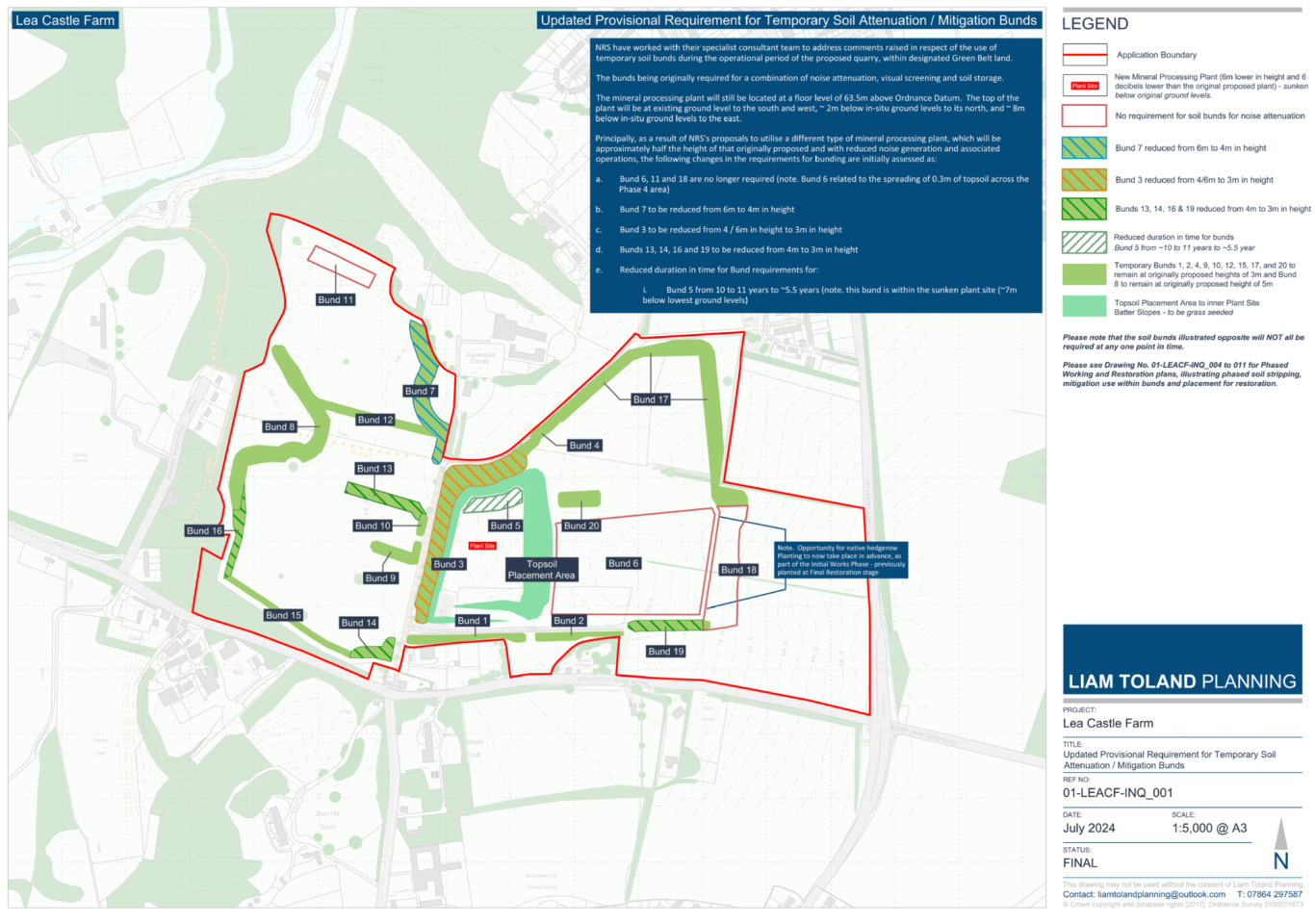

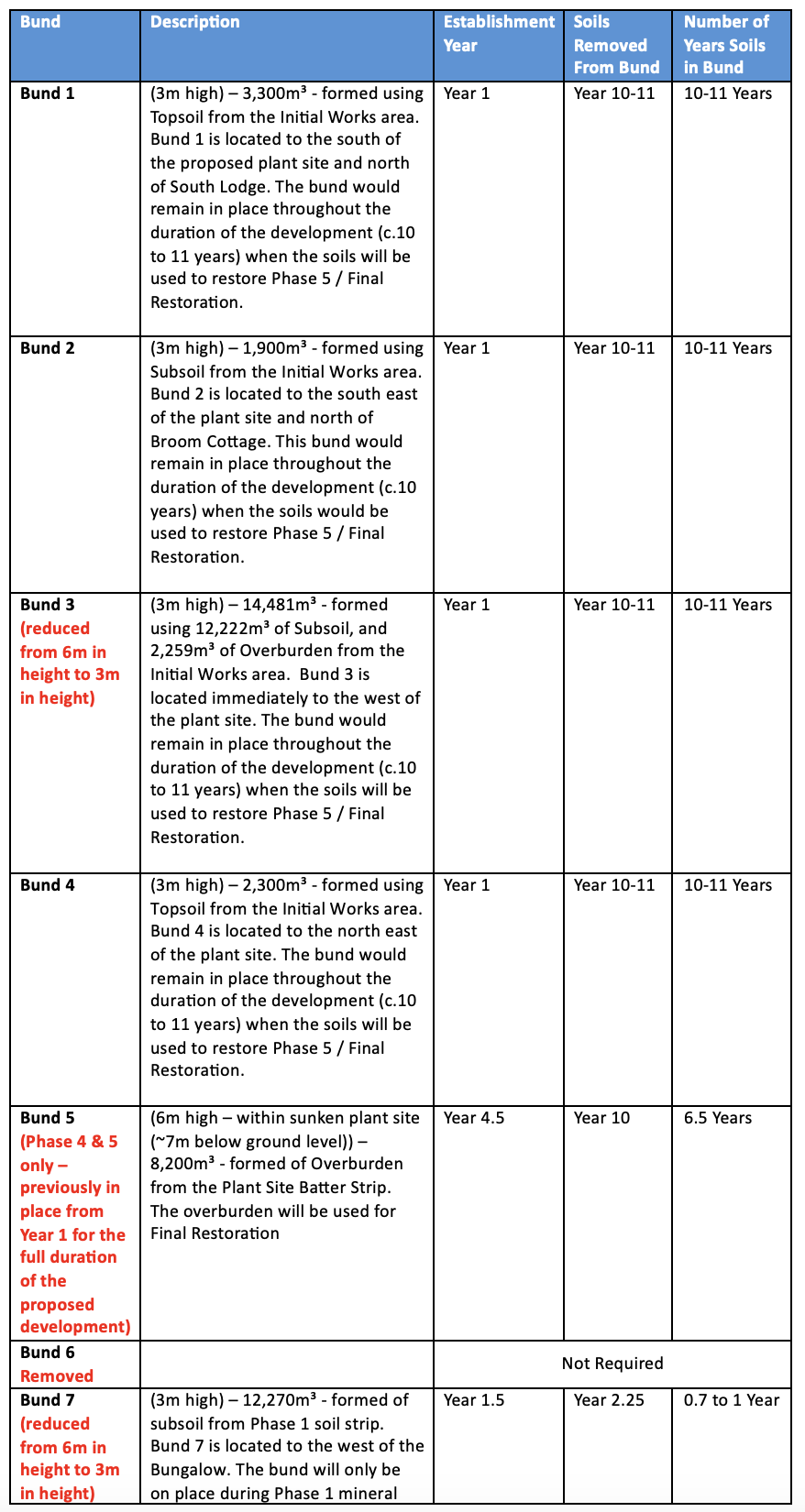

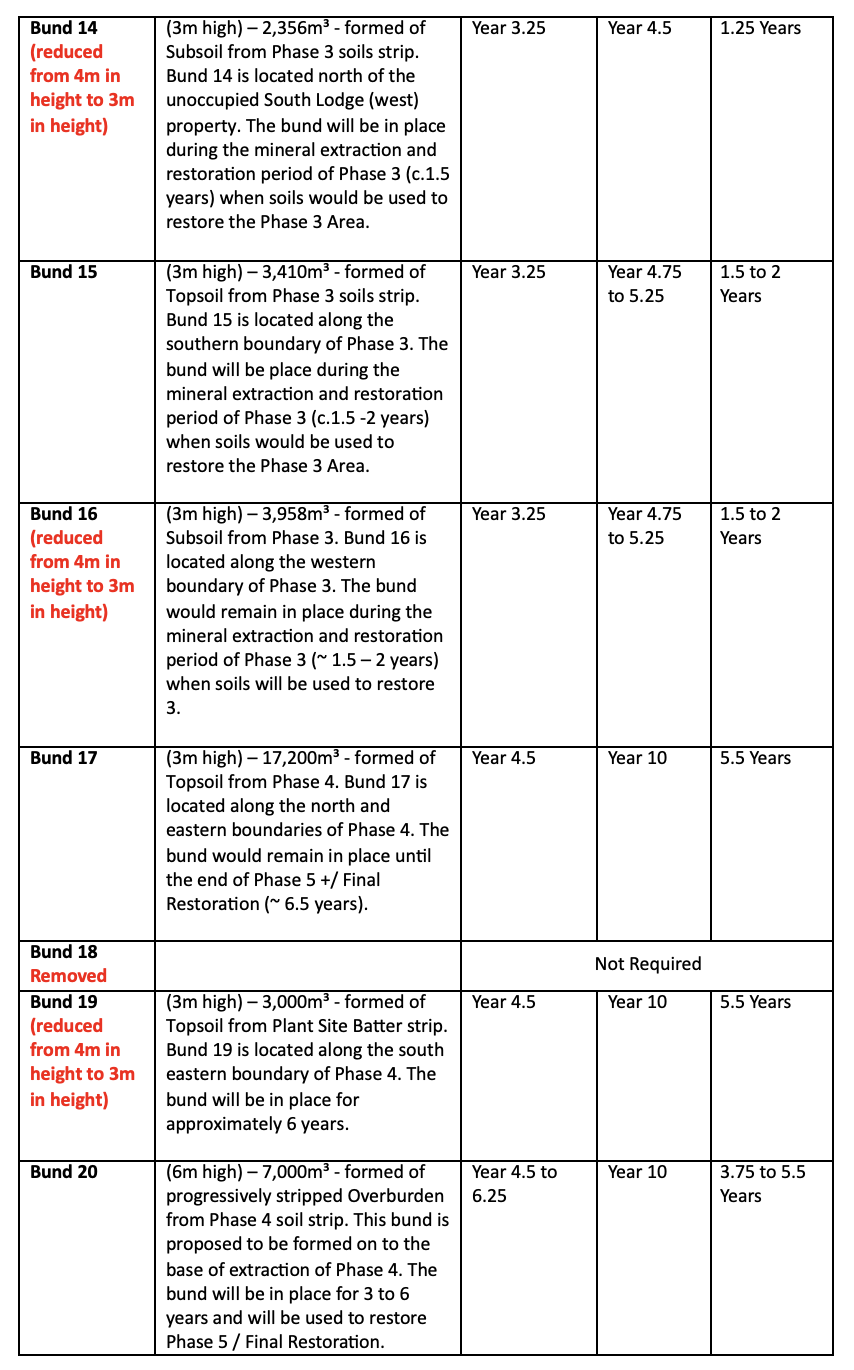

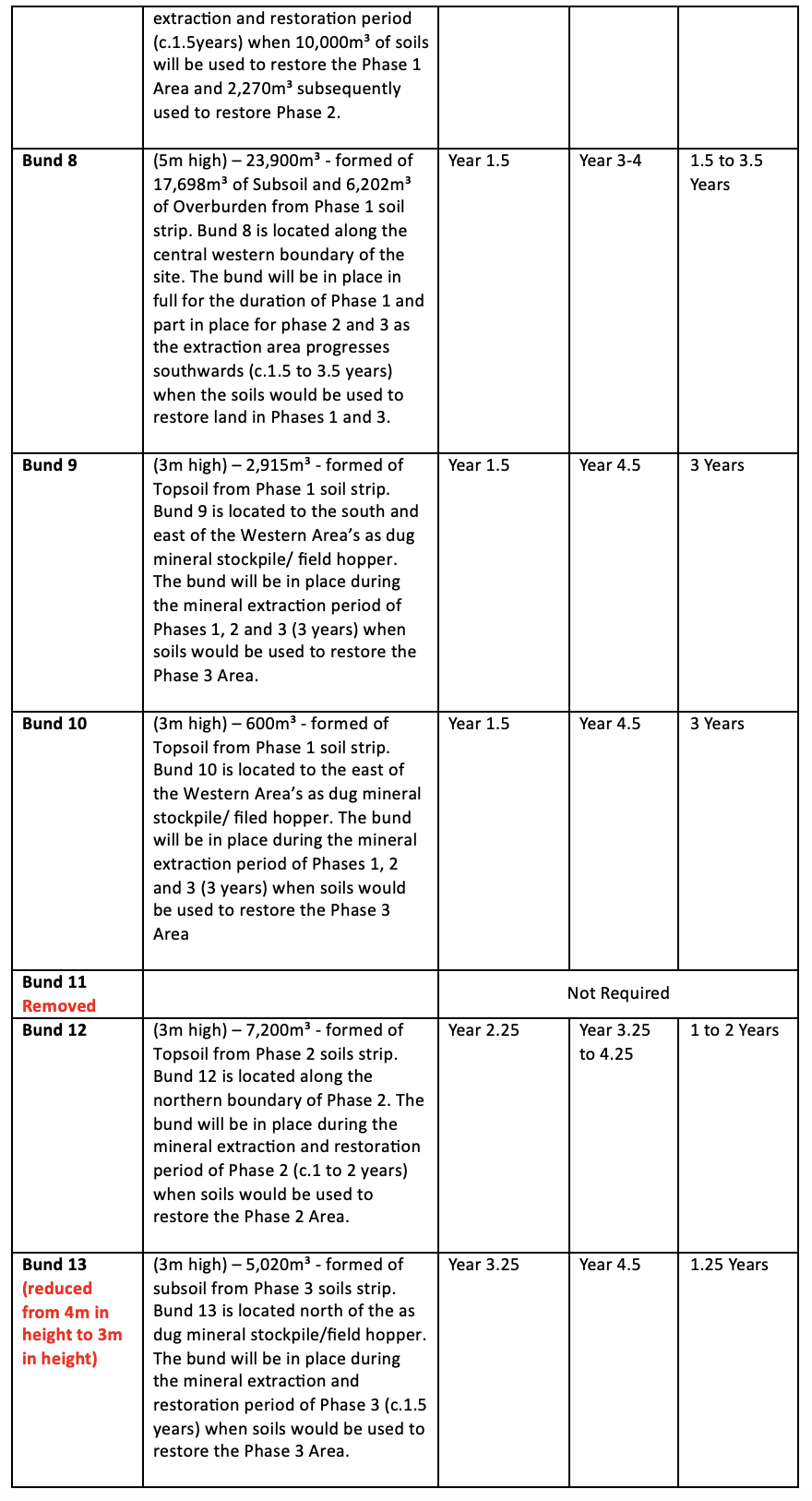

The plan opposite and sections below illustrate the Plant Site area, which will be constructed within the Initial Works Phase of the development. The Plant Site is set a minimum of 7m below existing ground levels. A small section of conveyor would be installed (conveying extracted mineral to the Plant Site from the Western Extraction Area) beneath the existing central access track and public right of way (PROW). Continued access will be maintained.
